Amortization Schedule Out of Balance
The situation: The contracts amortization schedule is
out of balance to the contracts economics. The users receive a “Current values do
not amortize” error.
The solution: Preform a non-economic contract modification
to correct amortization balance.
1. Open Contract
2. Fill out rewrite section
a.
Rewrite
type: Contract Modification
b.
Date:
Todays Date or next available date in January
c.
Reason
code: Any
3. Modification: A simple
non-economic Contract Modification would be to enter in an amount in the
Estimated Amount Financed field. There are no implications of adding a value in
this field. Usually it is just used for reporting or documents. I have entered
in the amount financed to this field for this example.

4. Click Post

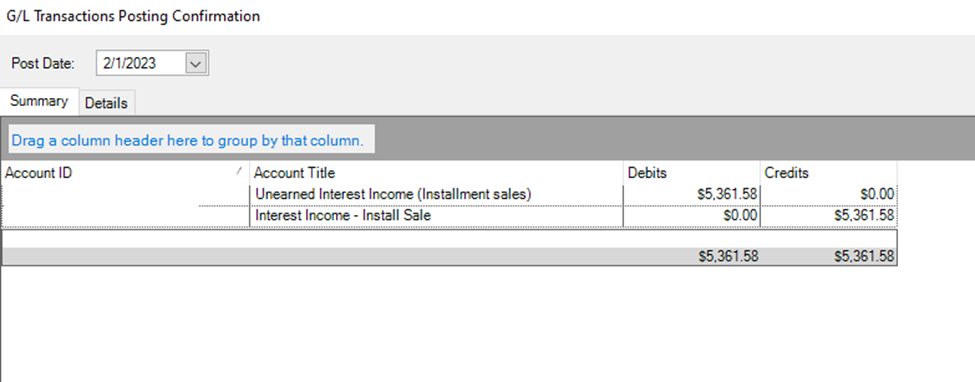

5. GL entry rolls up earnings to
correct.
6. Amortization schedule is corrected

Related Articles
Using Contracts from a Work Queue as Your Selection Criteria for a Trial Balance
See attached video for a demonstration In ASPIRE version 5.18 we added the ability to enter contract ID(s) directly into the the parameter field instead of choosing a range. What some people may not realize is how easy it is to paste results from a ...
Update Jobstream Schedule
In ASPIRE, go to Administration -> Jobstream Select the jobstream job that needs to be updated. In the Schedule section, update the schedule to the desired date/time. If the save icon does not activate, make a change to the Job Name field, then ...
Legal Balance of a Contract
Calculate a contract’s “Legal Balance” as the sum of all GL Debit and GL Credits under the following GL Interface Account Types: · AccountsReceivable · AccruedInterestReceivable · AccumulatedDepreciationEquipment · AccumulatedExpenseCIType · ...
VAT Schedule Configuration + ASPIRE Usage
Please see the attached document for details. A VAT Schedule presents the upcoming 12 months of scheduled invoice activity for a given contract. VAT Schedules are produced on an annual basis on the anniversary date of the contract commencement. When ...
Contract Modification - Payment Schedule Restructure Video
A 6 minute video of a contract modification that skips 6 payments and includes a rate change. Click here for the video.
